News and Updates

Project Updates

If you would like to be added to the newsletter distribution/mailing list, please contact: ProvincePost@TCBINC.org.

Construction is expected to be complete in Spring 2026. Our team will begin providing lottery/application information in February 2026. We hope to be able to provide the most up-to-date information regarding income limits and eligibility, required paperwork, etc. at that time.

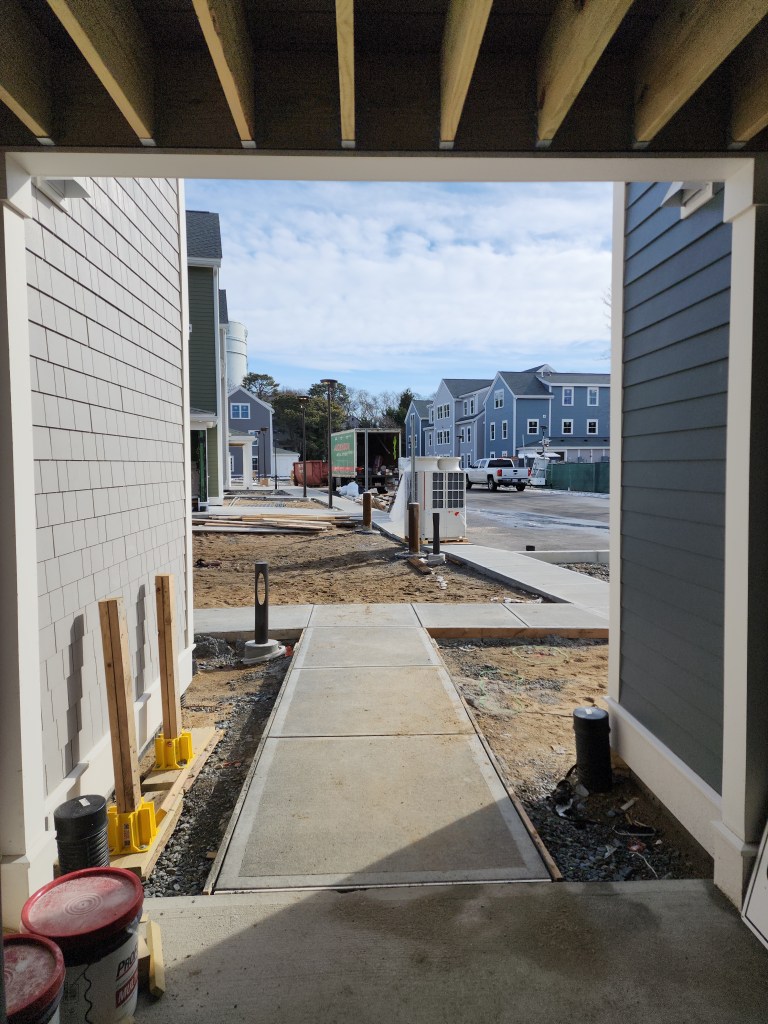

January 30, 2026

There continues to be progress, despite winter conditions!

Building C is working towards final inspections, with installation of HVAC units ongoing. Building D and A are in various stages of finish work, with electric and plumbing fixtures being installed. Finally, sheetrock at Building B has begun. Due to the frigid temperatures, site landscape will be held off until spring, with prep work for lighting and utilities being done when possible.


December 19, 2025

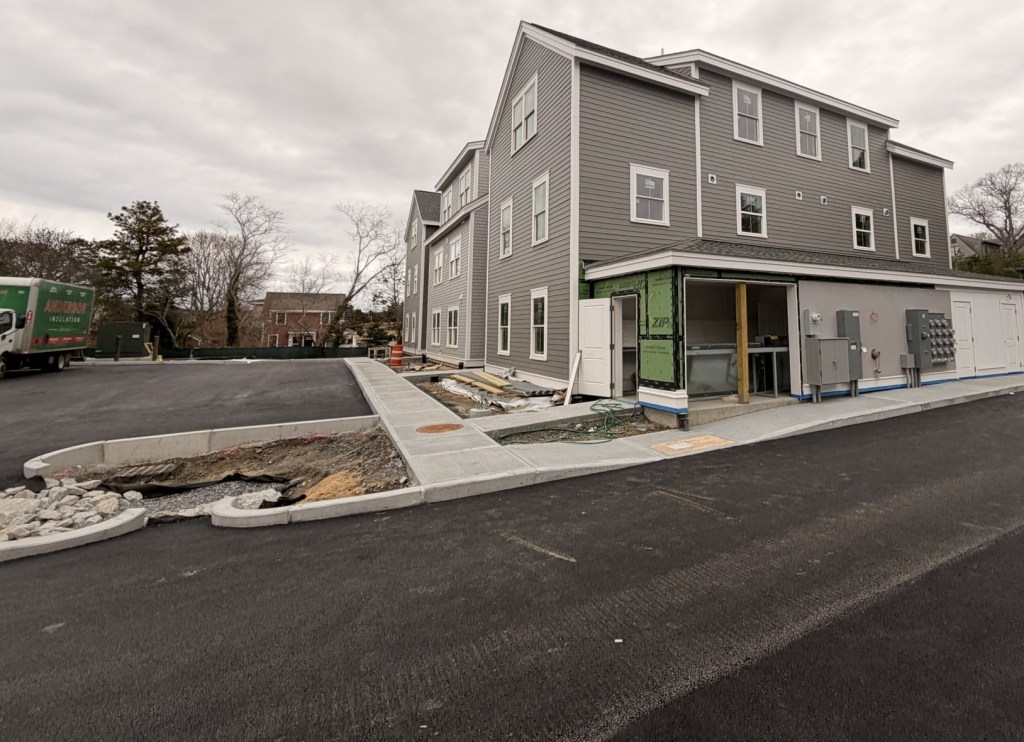

Major exterior work is wrapping up at Province Post, including final paving, sidewalks, and grading. Exterior siding is near completion across all four buildings, while interior work is moving forward with each building progressing through its own phase of finishes. With the Town’s support, Province Post will also be connected to the municipal sewer line!

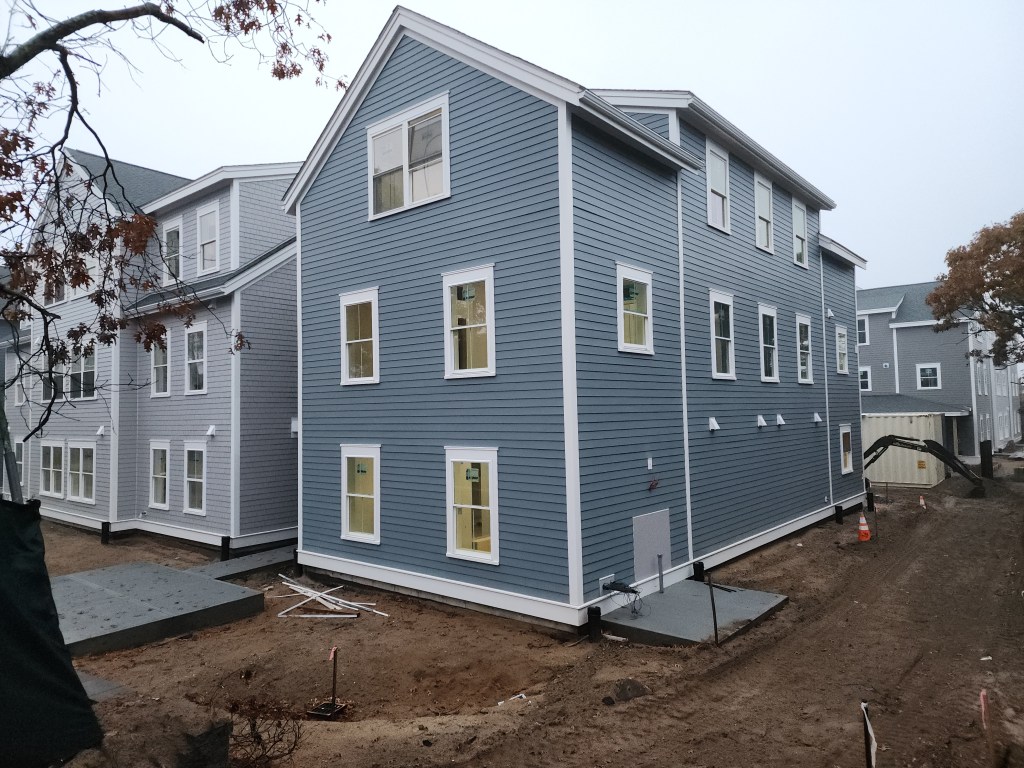

November 13, 2025

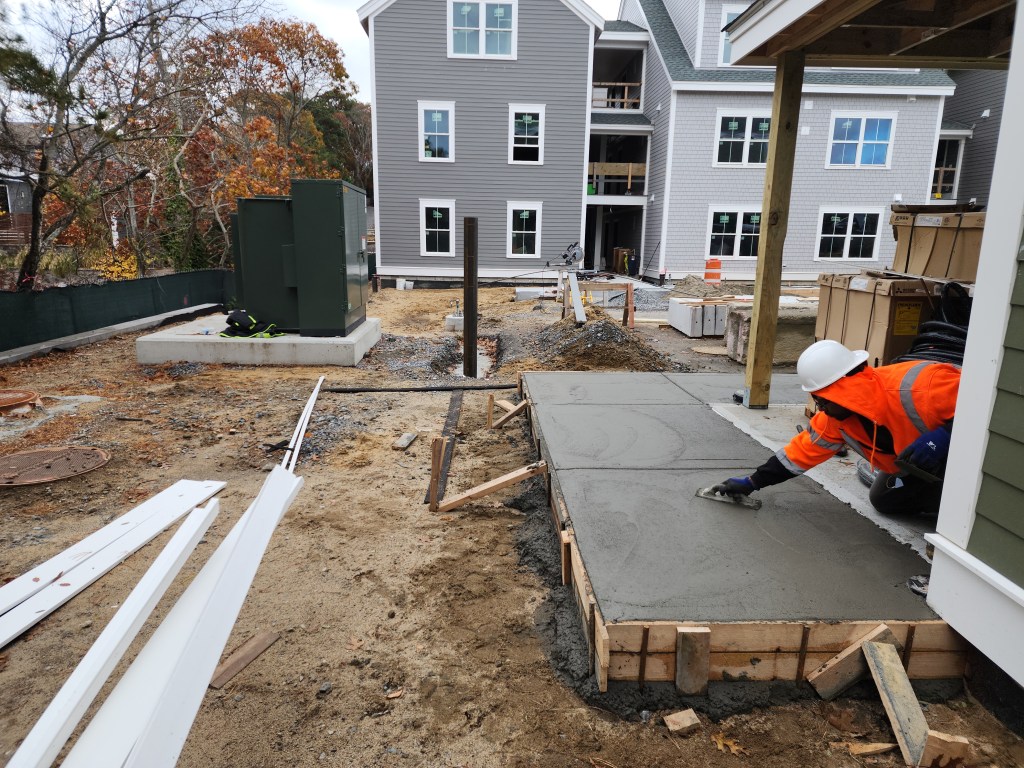

As many are preparing for the start of the holiday season, progress is quickly moving forward.

Interior finishes like flooring, paint, and cabinets are ongoing in Buildings C & D. Drywall hanging is ongoing in Buildings A & B. Lastly, MEP install & insulation is wrapping up in Building B. Outside, sidewalk pouring is ongoing and asphalt laying will begin next week.


October 17, 2025

It is getting chilly outside, but progress is still happening on the inside and the outside.

Site work prep for parking and sidewalks are ongoing. Mechanical and electrical rough-ins and inspections are ongoing in Buildings A, B, and D. Unit finishes and exterior building details are beginning to be installed in Building C.

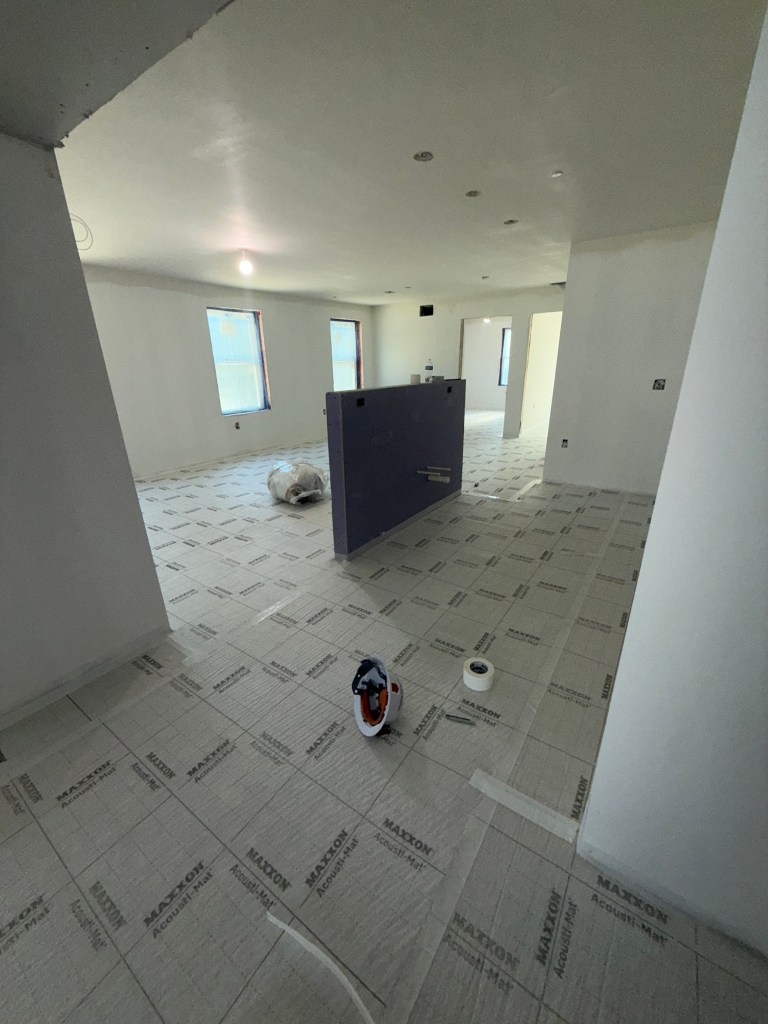

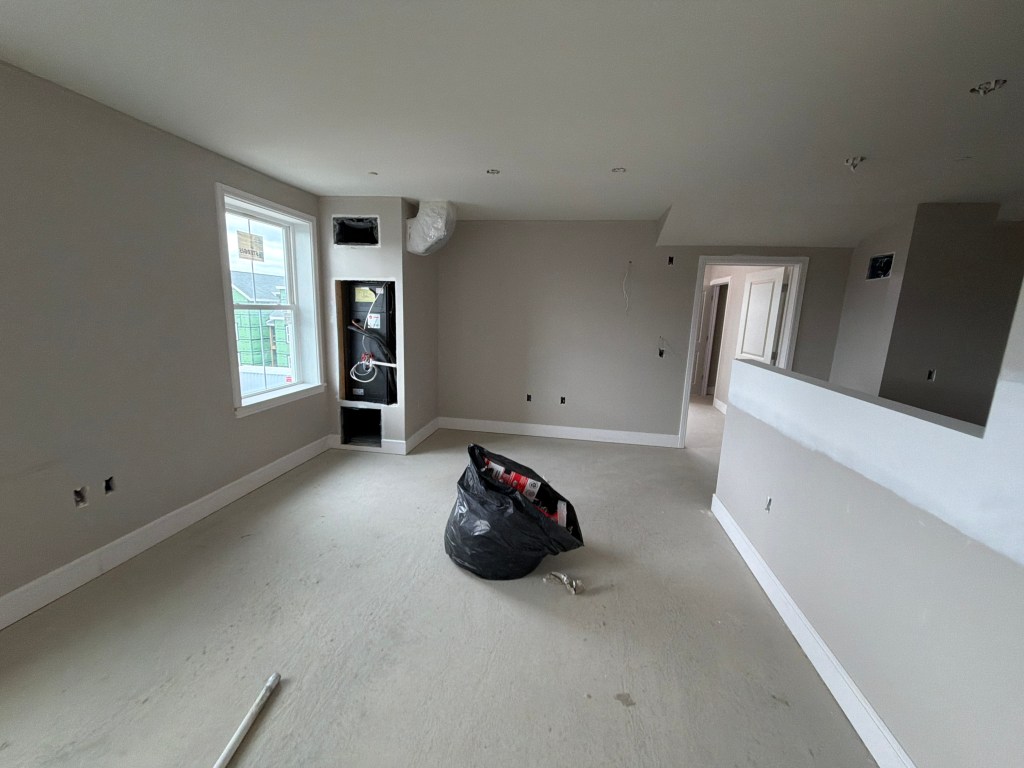

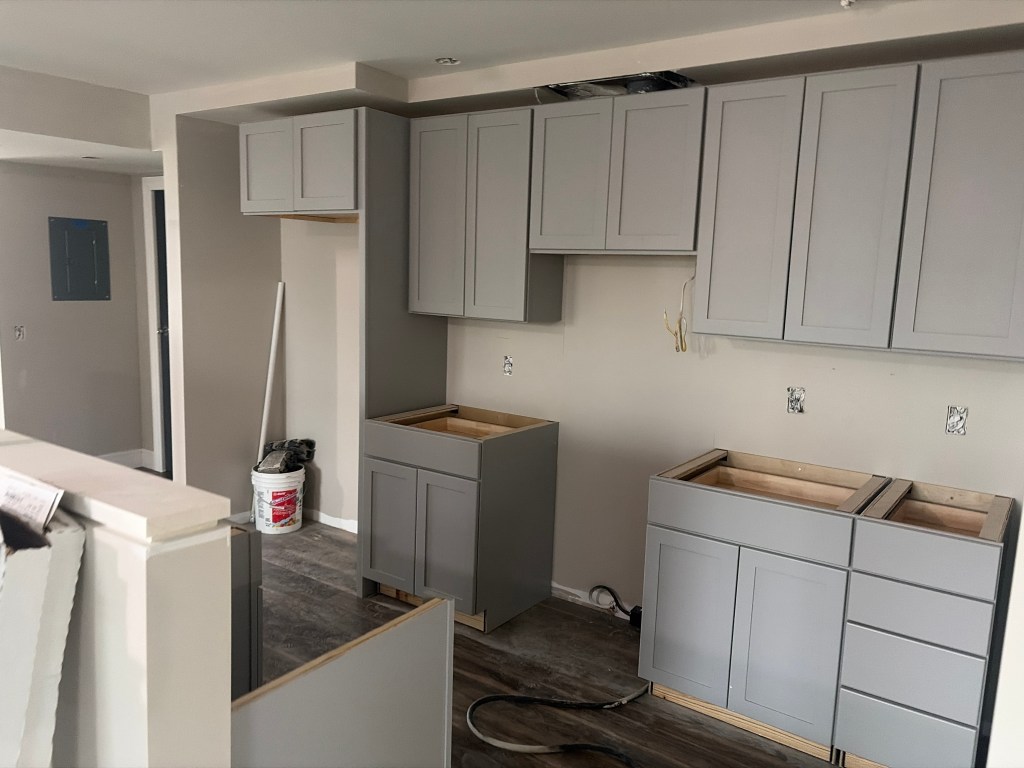

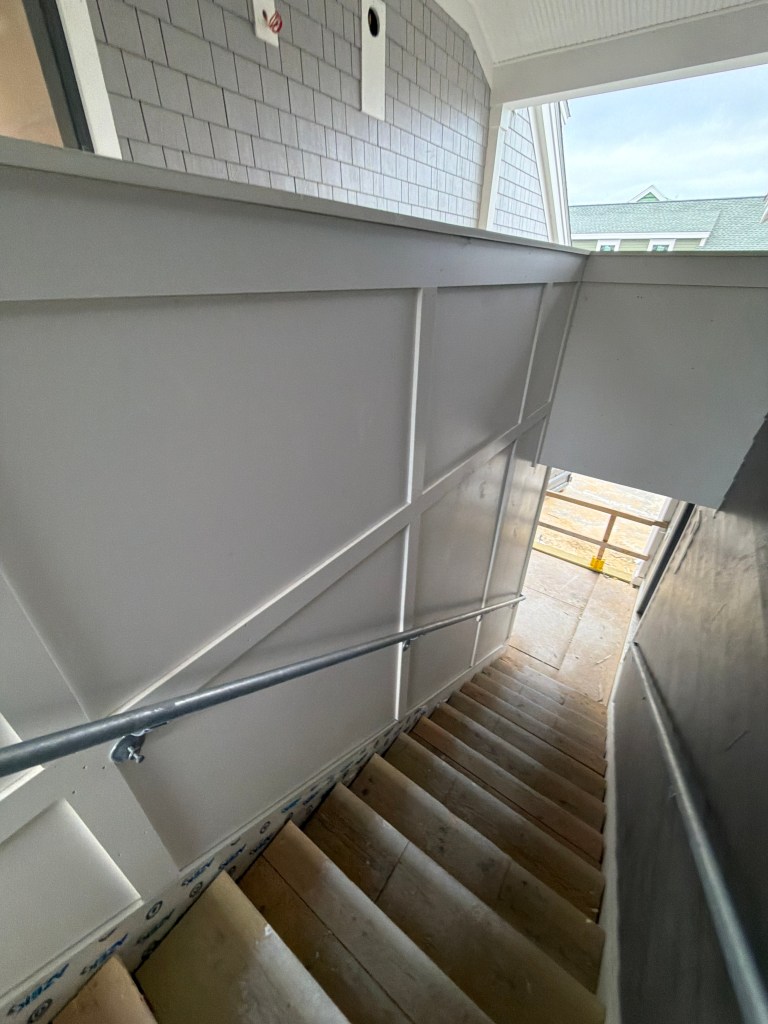

Are you curious about what the units look like on the inside? Take a look through the pictures for a sneak peak 🙂


September 26, 2025

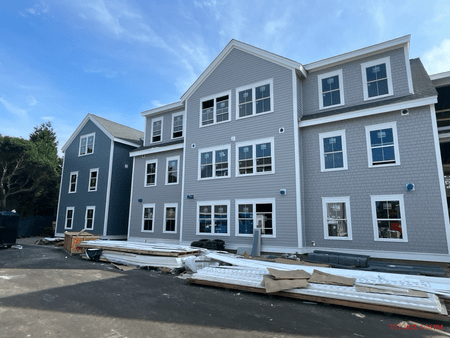

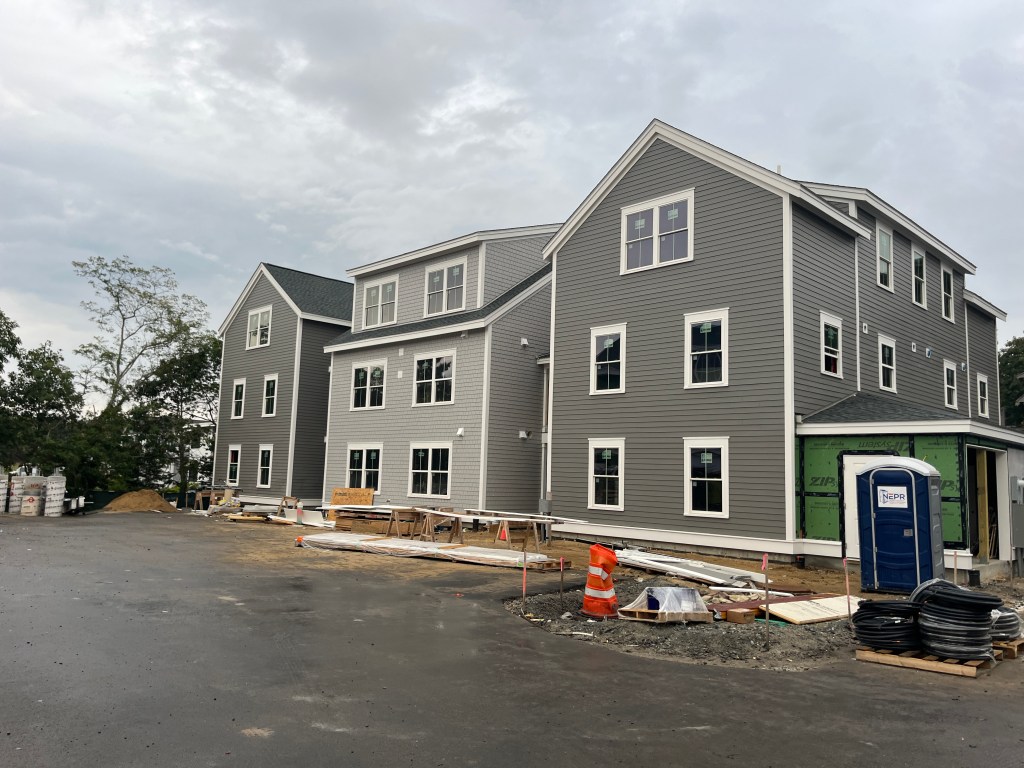

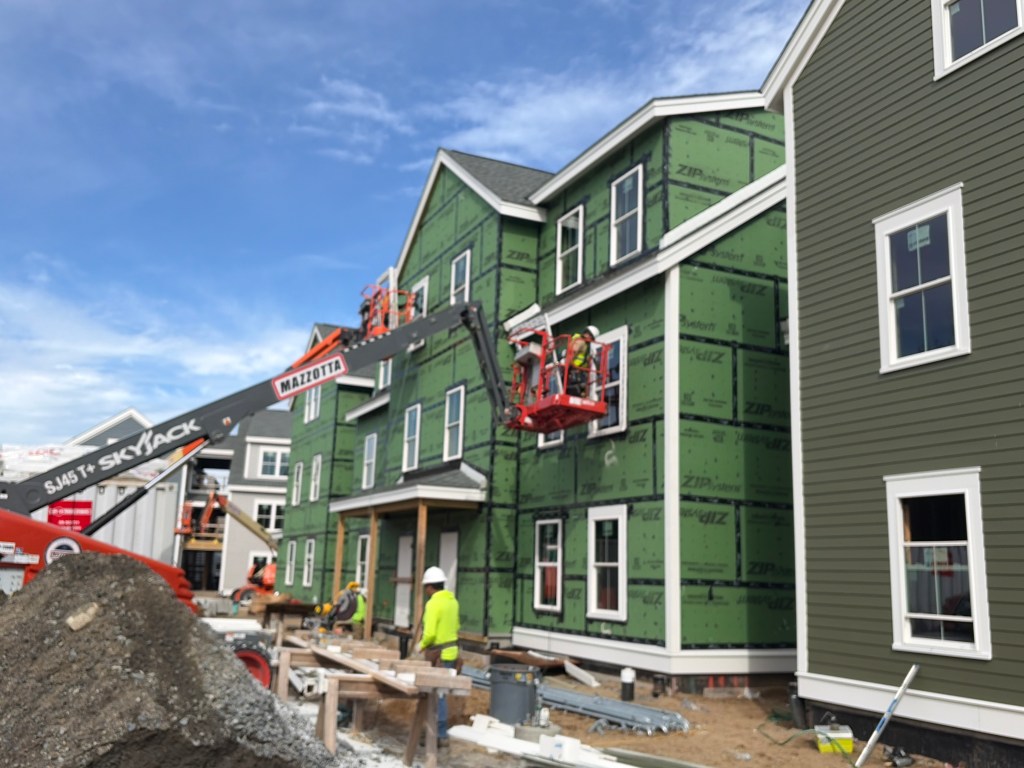

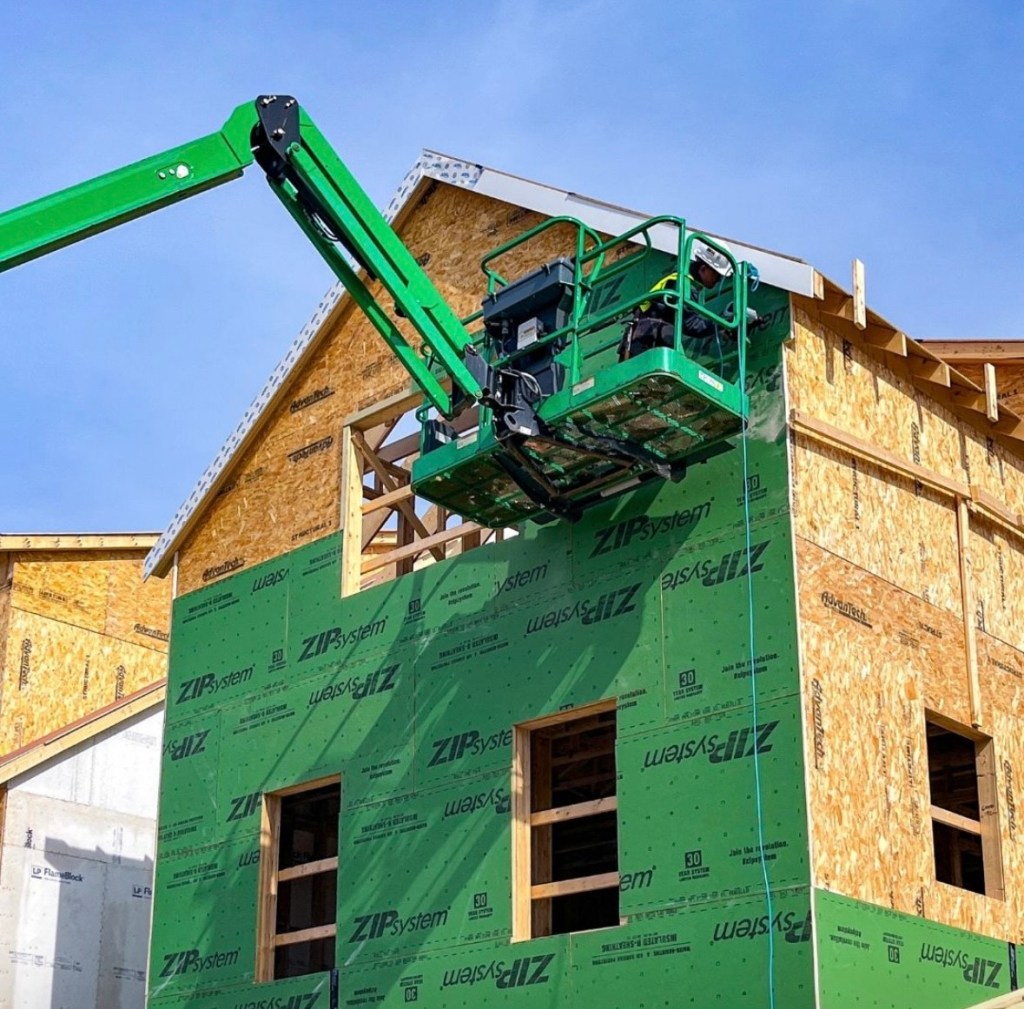

So much has been done, but there is still more to do. All the Buildings have siding and windows and exterior painting is ongoing. Meanwhile, drywall installation and interior painting has begun in Buildings D and C.
Additionally, TCB representatives will be at the Provincetown Housing Resource Fair at Provincetown Town Hall 260 Commercial Street on Tuesday, September 30, 2025 to share updates on the development. We look forward to seeing you there!

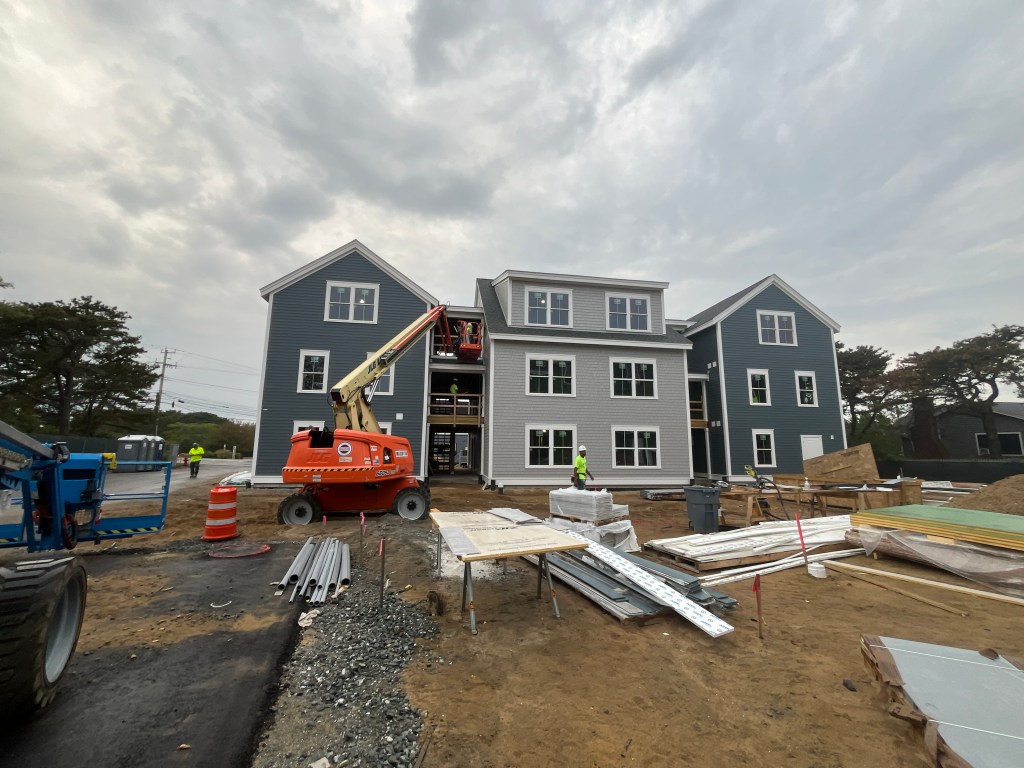

August 14, 2025

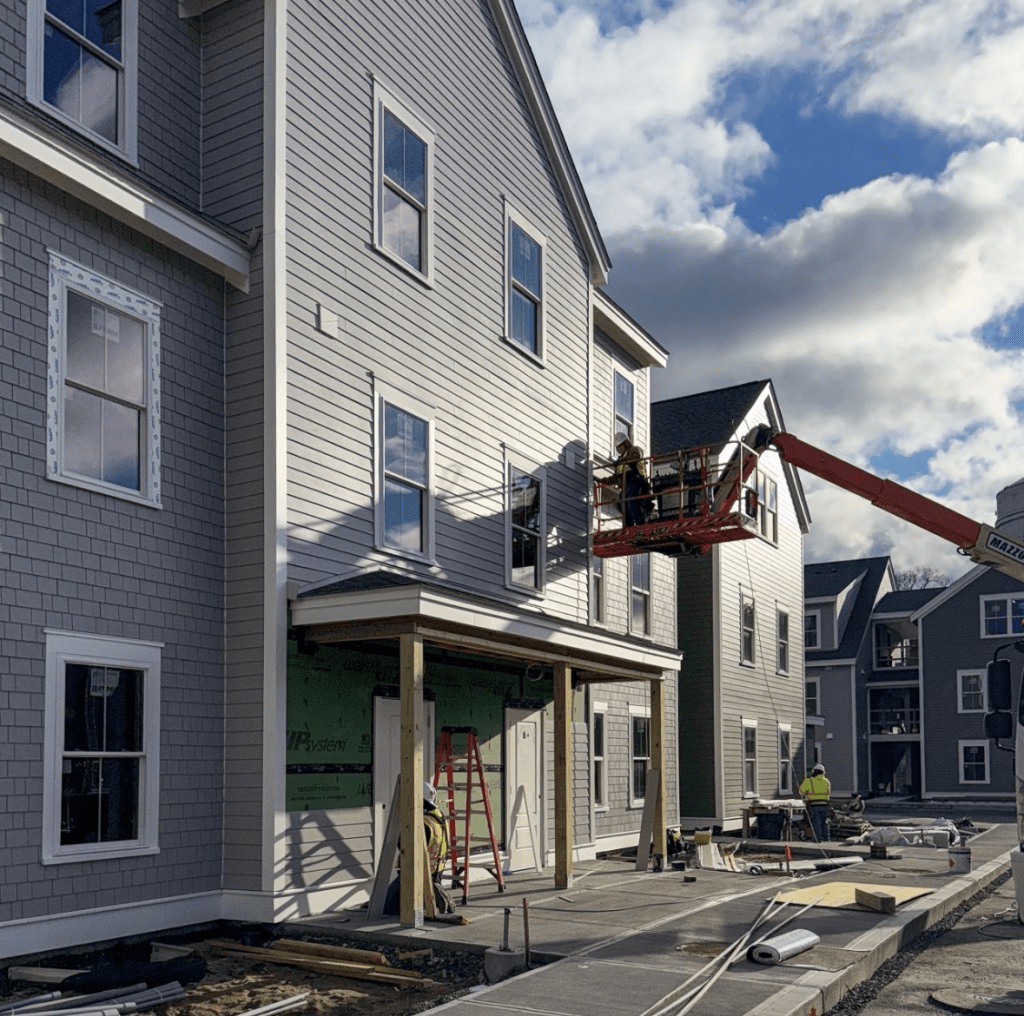

Building’s are Up! Window installation and siding work is nearly complete for all buildings. While work to the site exterior drainage is ongoing, work on the
buildings will move predominantly inside. Rough mechanical, electrical and plumbing are at various stages in Buildings A, B, and, D. Drywall installation has begun Building C.


July 18, 2025

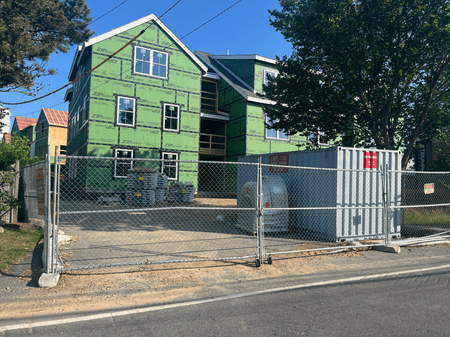

Construction activity is continuing as all our buildings exterior framing is almost complete. Window installation is ongoing for Buildings A & B, and siding has started or will start this month for all four buildings. Rough mechanical, electrical and plumbing are at various stages in each, with inspections ongoing with the town.

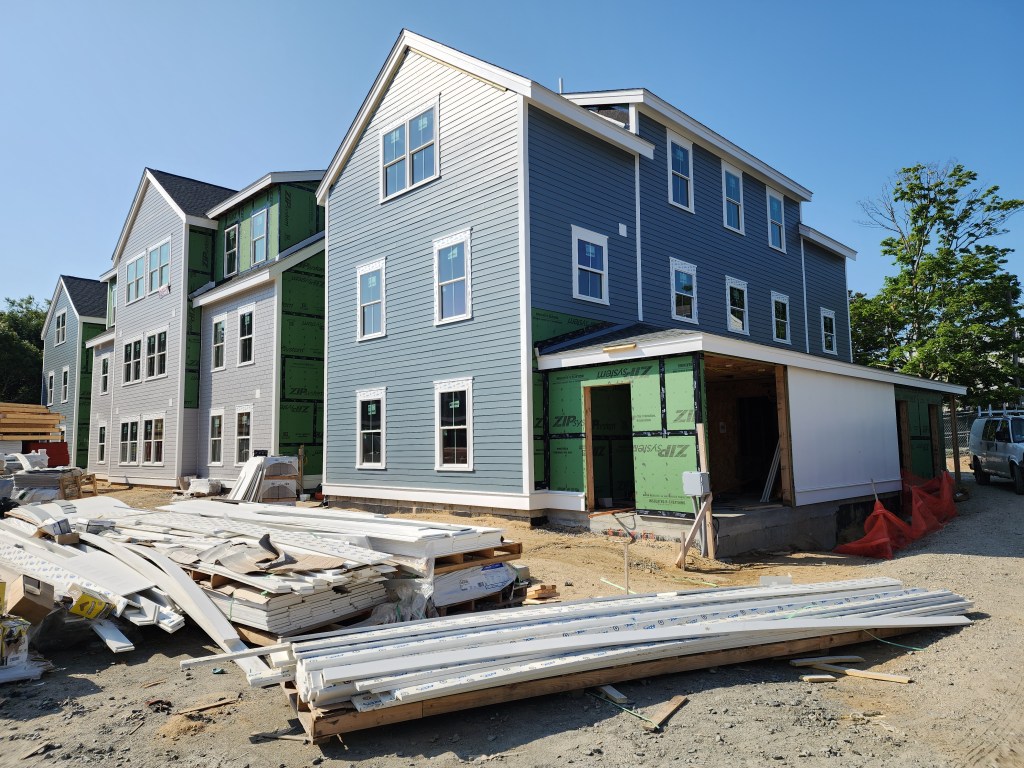

June 20, 2025

With final drainage field complete, Province Post is gearing up for a fresh look! Delphi Construction, the general contractor, will begin to add the first layer of pavement to the site. Rough MEPs are also wrapping up in Building C and moving along in Building D. Framing has topped off on Building A, with window installation starting soon, and Building B has reached the roof.


April 24, 2025

Construction activity is picking up across the site. Framing is well underway on Buildings C, D, and B, while Building A is set to follow. On-site, rough MEPs (mechanical, electrical, plumbing) are moving forward in Buildings C and D. At the same time, utility work is progressing with transformers set and electrical service installation underway across the site.

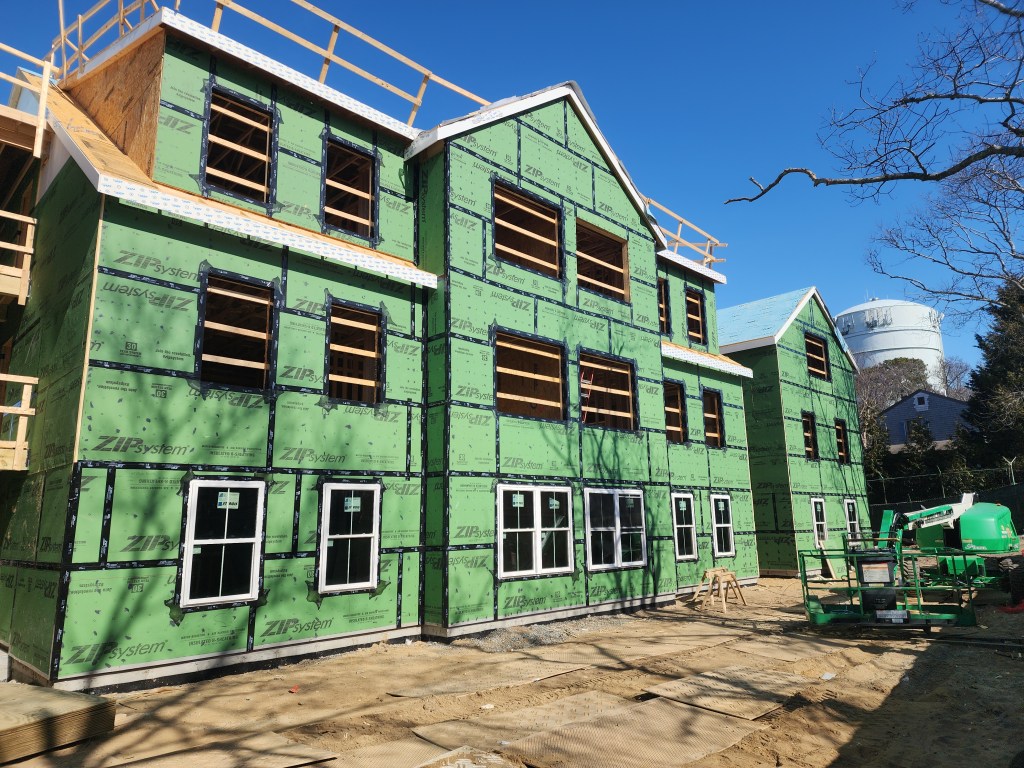

March 28, 2025

Spring season is here! Delphi Construction (general contractor) continues to frame Buildings D and C. Once foundation work is complete, framing will then begin on Buildings A and B. In addition, roofing and windows will be installed to make the buildings weather-tight, allowing interior trades to begin their work.

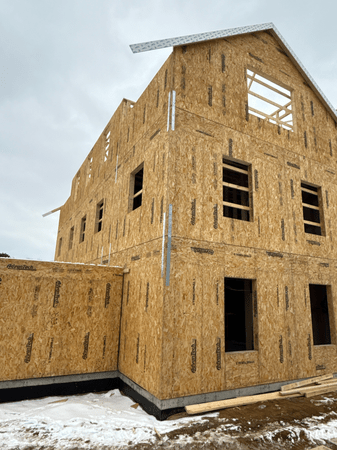

February 25, 2025

Despite the cold temperatures, work continues to progress on site.

Building C’s third floor deck and walls are installed. There is also ongoing concrete placement in Building C’s breezeways. Installation of Building D’s first floor has begun, with sill plates installed. Foundation work also continues or Buildings A and B.

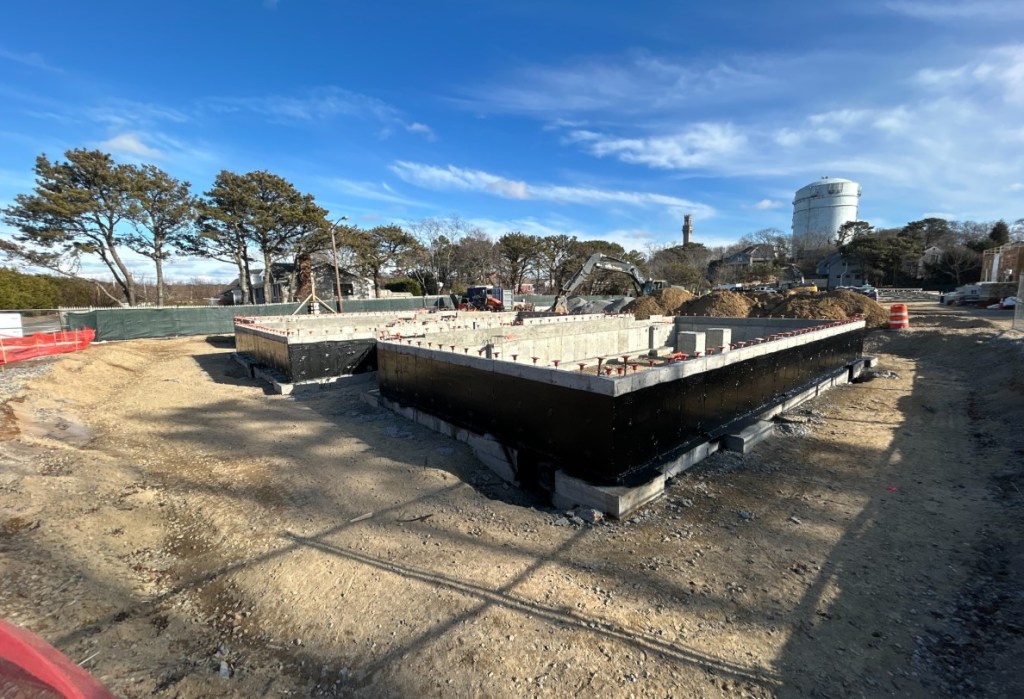

January 21, 2025

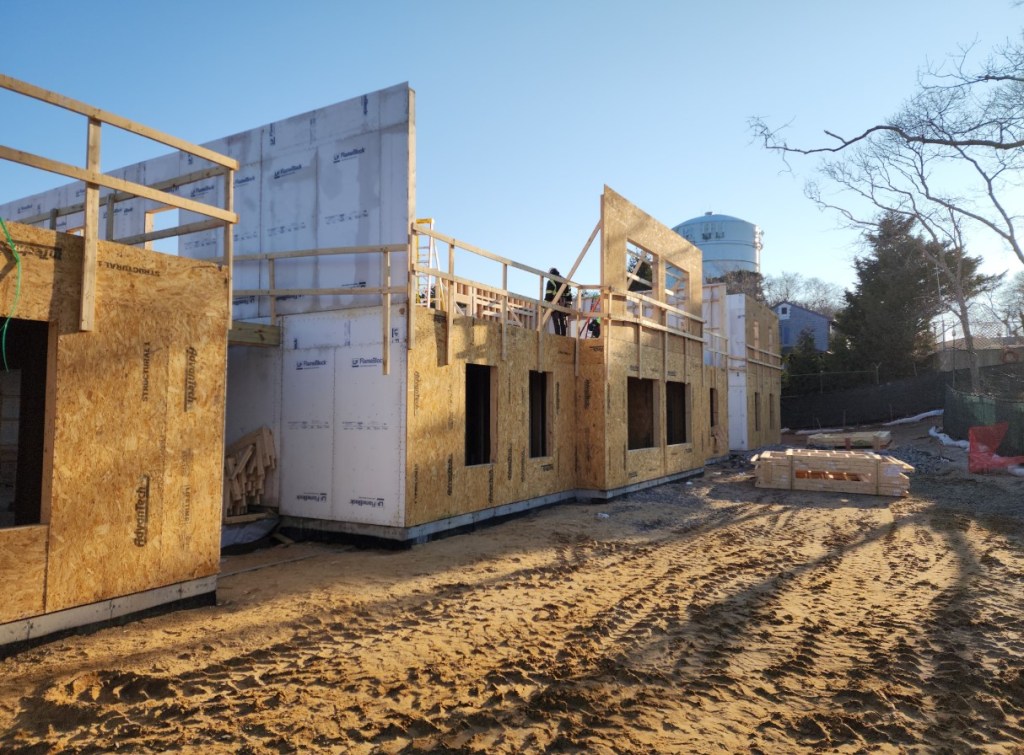

Delphi Construction (the contractor) has started to go vertical on Building C, with panelized wood framing on the first and second floor. Layout of Building D has begun with wood framing expected to start soon. Buildings A and B continue to have ongoing foundation work, with slab pours slated for the coming weeks. Underground utility connections are also ongoing with the completed slab pours and will continue as concrete is placed.

In February, rough electrical, mechanical, and plumbing work will begin in Building C and will continue through Buildings D, A, and then B.

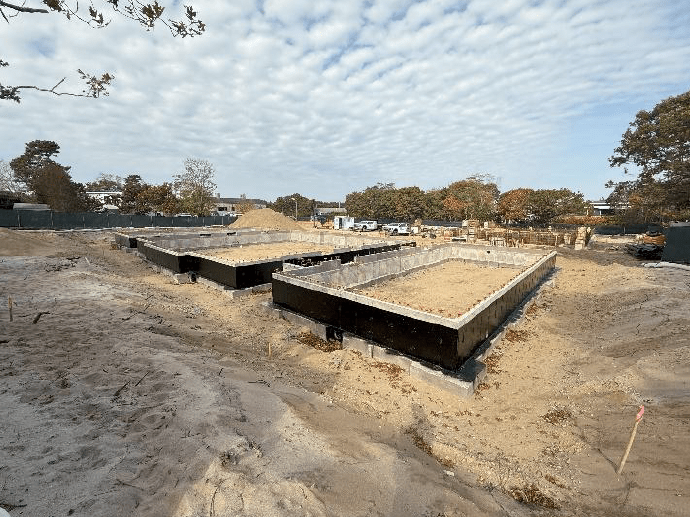

November 8, 2024

Construction is moving along at the Province Post site. Underground structures for stormwater and utilities are partially complete. Major excavation and foundations are complete for two of the four buildings (Building C and D). Soil compaction and concrete formwork are in process for the other two buildings. Utilities within the building footprints are being placed prior to the backfilling of foundations and slab pours.

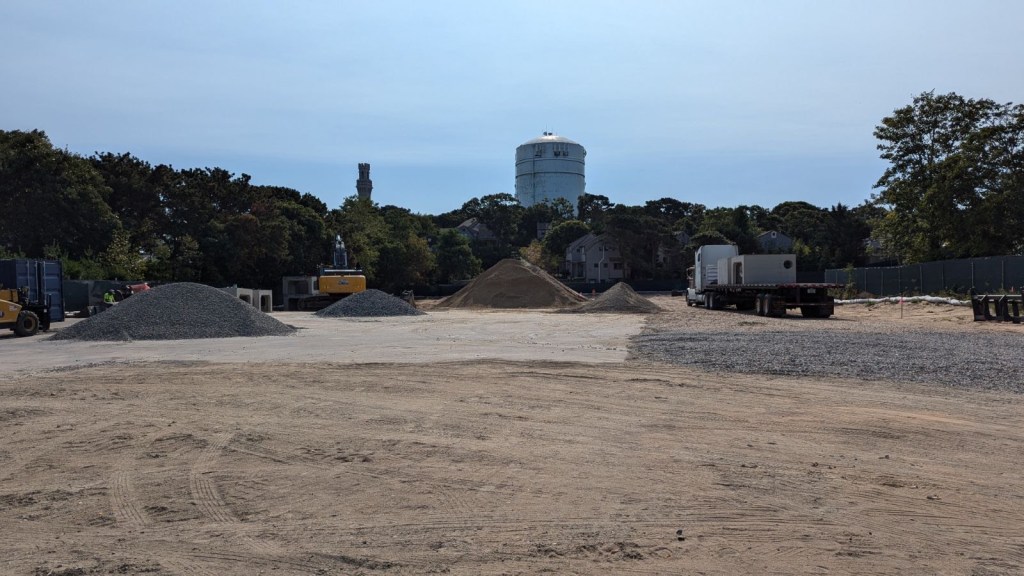

September 30, 2024

Early site preparation work is complete, and the installation of the drainage field is now in progress. Delphi Construction (contractor) has started preparations for the foundation. Preparation includes soil excavation and removal, soil compaction, and concrete formwork for footings and foundation walls.

Concrete pours will begin and continue through the Fall as the contractor moves through each of the four foundations.


July 24, 2024

Delphi Construction, the general contractor for Province Post, will begin construction on Monday, July 29, 2024. For more information, please review the latest newsletter below – which was emailed to direct abutters and individuals who have opted into the contact distribution list.


June 6, 2024

The Town of Provincetown and TCB will be hosting a groundbreaking ceremony on Tuesday, June 18, 2024 at 1:00pm. TCB, along with project funders, is working towards a construction closing and start, which is expected to take place in July 2024. The latest newsletter was emailed to direct abutters and individuals who have opted into the contact distribution list. You can view the newsletter below.


November 8, 2023

TCB held two community/abutter meetings: an in-person meeting at VMCC on Tuesday, November 7th at 5:30pm and a virtual meeting on Wednesday, November 8th at 5:30pm. Both meetings covered the same content. Presentation from the meeting can be downloaded below.


September 19, 2023

Going forward, TCB will be sending out newsletters to keep the community informed about key updates to the Province Post housing project (formerly referred as 3 Jerome Smith). The fall newsletter was sent by mail and emailed to direct abutters and individuals who have opted into the contact distribution list.

You can also view the fall newsletter below:


June 22, 2023

A hybrid community/abutters meeting was held at the VMCC at 5pm on Wednesday, June 21st. The presentation from the meeting can be downloaded at the bottom of this page. Follow-up communications from that meeting will be forthcoming.


May 18, 2023

TCB is pleased to share the news that the 3 Jerome Smith Road was granted a funding award from the Massachusetts Department of Housing and Community Development (DHCD). 3 Jerome Smith was 1 of 27 projects that was awarded funding in a very competitive application round. This important milestone allows to project to proceed to closing and construction start, with a goal of starting construction in spring 2024.

The DHCD press release is here: https://www.mass.gov/news/healey-driscoll-administration-announces-246-million-to-build-and-preserve-1600-affordable-and-mixed-income-housing-units


Summary of 3 Jerome Smith Road Housing Project process

TCB has held and attended numerous meetings with the Community and Abutters of 3 Jerome Smith Road since February 2021. The team received positive feedback from the Select Board and community, supporting the proposed design, program, and density as a critical step to helping address the housing crisis in Provincetown.

In September 2022, TCB presented the project to the Provincetown Zoning Board of Appeals (ZBA) and was granted zoning approval in October 2022.

In January 2023 TCB submitted an application to Massachusetts Department of Housing and Community Development (DHCD) requesting State funding for the project. In advance of the DHCD application, TCB presented a proposed unit mix change to the Select Board. TCB has proposed that 4 of the 60% AMI units become 30% AMI units and that the 16 units targeted for 80-120% AMI households, be capped at 80% AMI. This change enables the project to earn Low-Income Housing Tax Credits (LIHTC) on the 80% AMI units by utilizing the LIHTC Average Income Test (AIT) rule and thereby unlocking approximately $3MM in additional federal funds and equity. This change is essential to funding a budget gap and enabling the project to move forward to construction start in early 2024.

DHCD made an announcement on May 18th that the 3 Jerome Smith Road project was approved for its soft loan and federal and state low-income housing tax credit request. With this approval of funding, the project can continue forward with the hopes to start construction in Spring 2024.


Estimated Project Schedule

2022Early 2022 – Initial community engagements/input Summer 2022 – Zoning process begins Fall 2022 – Applications for local funding sources
2023Early 2023 – Application for State funding
Summer 2023 – State funding award
2024Spring 2024 – Closing and Construction Start
2025/2026End of 2025 – Construction Completion; Lottery; and Lease-Up

Archived Project Updates

APRIL 2022: In response to abutter comments and concerns, TCB has revised our plans to help address some of the abutters concerns. The updated plan eliminates the one-way vehicular drive onto Captain Bertie’s Way and replaces it with a pedestrian path at that location. The updated plan also reorients the 2 buildings to improve buffering and adjacency with abutting properties, and creates 10 additional parking spaces on site. These changes address many of the concerns raised by abutters while still ensuring the project meets the larger community’s needs for affordable housing. This updated configuration was presented to abutters at the April 27 virtual meeting and again on July 21 to share the landscape and buffering plan. Additional details of the process and schedule can be found below, under Next Steps.

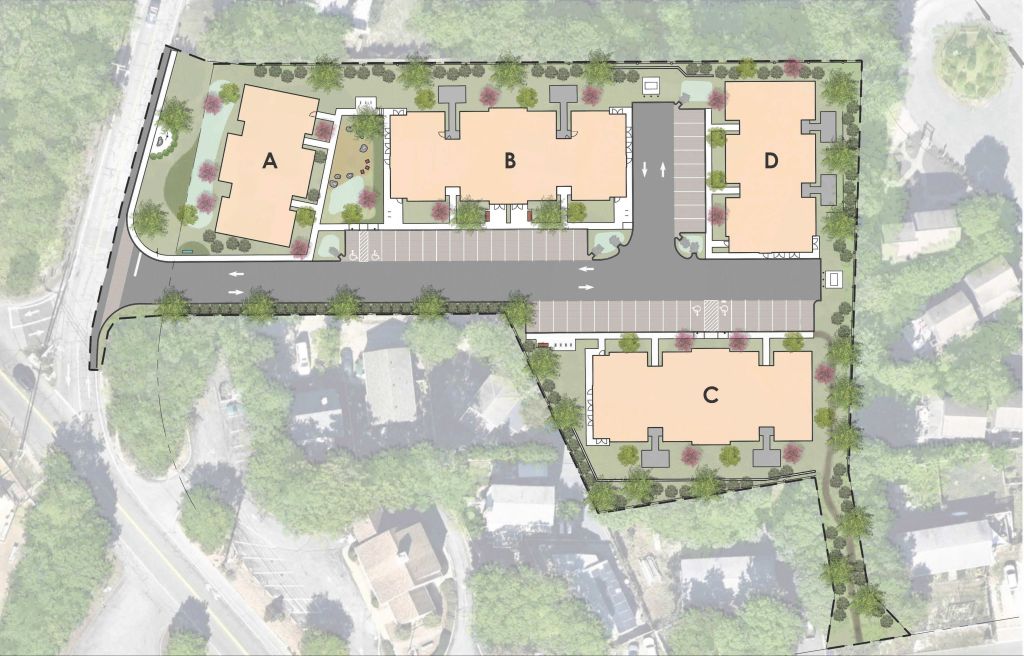

Updated Site Plan

Presentation from June 21, 2023 Abutter Meeting

Presentation from July 21, 2022 Community and Abutter Meeting:
